Roof Replacement Timeline for Ohio Homeowners: How Long Each Phase Takes

Fairfield Peak Roofing · · 8 min read
Ohio roof replacement timeline showing day-by-day installation phases

You just got the quote approved for your roof replacement. Now the question is how long your home will be a construction zone.

In Lancaster and across Fairfield County, the timeline varies with weather, permits, and hidden damage. A contractor may promise a short job. The whole project often takes longer.

The notes below are general guidance, not guarantees. Permits, materials, and weather can stretch the full project.

According to GAF, one to two days is often enough for an average home. That figure covers asphalt shingle roofs.

Step What the source says Source
Whole job, average homeOften one to two days (asphalt shingles)GAF, manufacturer
Tear-off to the deckingTypically a few hoursGAF, manufacturer
Rotted decking foundAdds a few hours to an extra dayGAF, manufacturer
Tight access, fences, landscapingCan add hours at the startGAF, manufacturer
Steep or complex roofSlower work, more cut shinglesGAF, manufacturer
Rain in the forecastMay split the job over two daysGAF, manufacturer
Final inspectionCall 24 hours ahead after tear-offClark County, Ohio form

The Clark County row is one county's rule. Your building department may differ.

Knowing each phase's timeline helps you plan around work schedules and protect your belongings. It also tells you when to worry if progress stalls.

Scheduling lead times can change from season to season. Ask contractors for current availability. See the report on roofing scheduling and wait times for background.

This guide breaks down a typical roof replacement timeline in Ohio, including common delays.

Phase 1: Pre-Construction

Before a single shingle comes off your roof, there is a preparation period. Most homeowners underestimate it.

Filing an insurance claim first? This construction timeline starts after approval. See our real insurance claim timeline for what happens before this.

Permits and Approvals

Many roof replacements need a building permit from your local building department. Some offices exempt like-for-like shingle replacement.

The City of Lancaster Certified Building Department does not publish a re-roof permit review time. Ask the city for current timing.

The city's minor building permit application lists re-roofing as a work type. It states no review time for re-roofs. Your contractor submits the application, which usually includes:

  • Detailed scope of work
  • Proof of contractor insurance and any required local registration
  • Material specifications that meet the Residential Code of Ohio
  • Site diagrams showing access points

Busy periods can slow processing, and delays here push back your entire timeline.

Clark County, Ohio publishes a residential re-roof application. It is one county's form, not Fairfield County's rules. Its 2026 form shows what a building department may ask.

  • It asks if the roof has two or more layers. If yes, the form says tear-off is required.
  • It requires full tear-off if the roof is water soaked or the shingles are curled.
  • It allows a maximum of two layers, if the first layer is undamaged and the maker approves.

Ask your own building department which rules apply.

Material Ordering and Delivery

Once you select materials, suppliers need time to prepare your order. Lead times vary by supplier and product, and this is general guidance, not measured data.

Material Type Relative Lead Time
Standard Asphalt Shingles Usually shortest
Premium Architectural Shingles Short to moderate
Metal Roofing Panels Often longer, especially if made to order
Slate or Tile Often the longest

Ask your contractor to confirm availability before you sign. Special items can run late. Extra ice barrier is one example.

Schedule Coordination

Quality roofing crews in Lancaster often book out in spring and summer. Winter projects may have faster availability. Weather considerations make winter a harder season to work in.

Ask contractors for their current lead time.

Permit Timing by Jurisdiction

Permit timing depends on where your home sits. Each office sets its own process.

  • Lancaster city limits: The City of Lancaster Certified Building Department does not publish a re-roof review time. Ask the city for current timing.
  • Unincorporated Fairfield County: Permits go through the county. Ask the county building department for current timing.
  • Canal Winchester, Pickerington, Reynoldsburg: Each has its own building department. Pickerington lies partly in Fairfield County and partly in Franklin County. Confirm which office handles your address with the city building department.

Work should not begin before the permit is issued where one is required. See our Fairfield County permit guide. Starting early can cause problems when you sell the home or file an insurance claim.

Phase 2: Tear-Off and Demolition

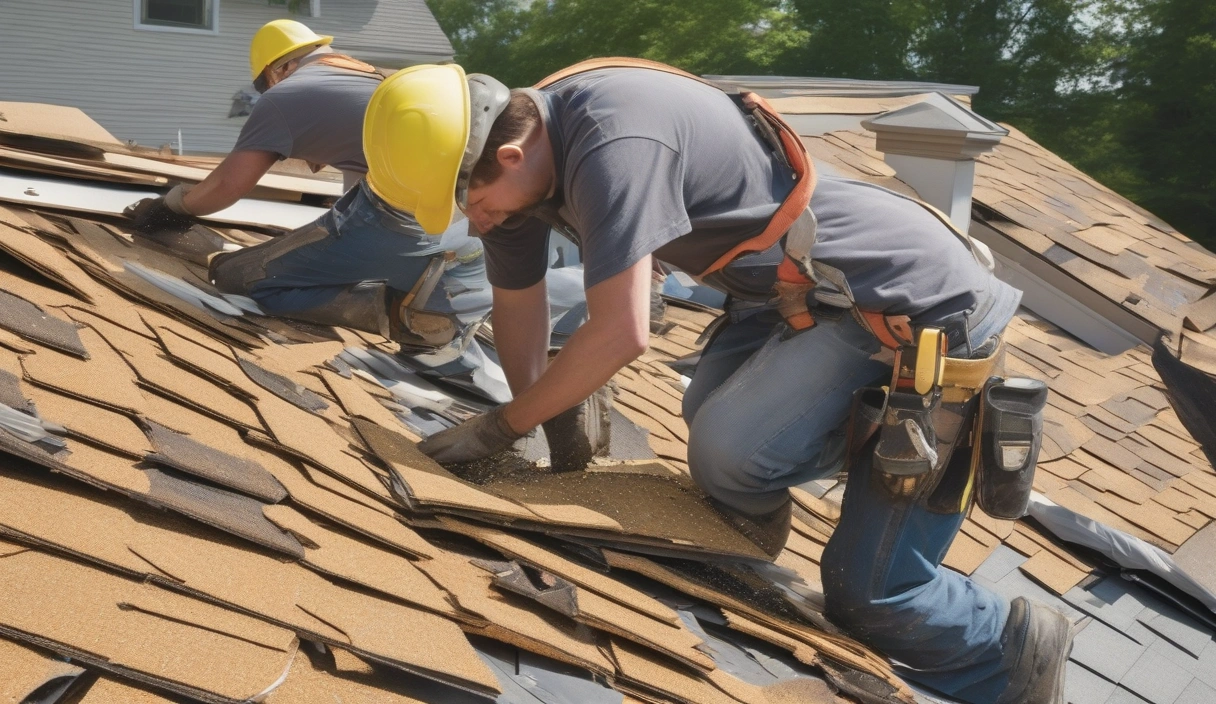

This is the loudest and messiest phase of your roof replacement. On many homes it is also the fastest.

What Happens During Tear-Off

Crews usually start early in the day. The process runs in this order:

Setup: The crew arrives and sets up the dumpster and safety equipment. They protect landscaping with tarps.

Active tear-off: Noise peaks as crews pry off old shingles. Vibrations may shake walls. They may dislodge pictures.

Cleanup: Debris goes into the dumpster. Any damaged decking found during tear-off is marked for replacement.

Larger homes or multiple layers of old shingles take longer.

According to GAF, tear-off to the decking typically takes a few hours. GAF notes that landscaping, close neighbors, or a fence can add hours at the start.

Hidden Damage Discovery

This is where timelines often derail. Once underlayment is removed, roofers frequently discover:

  • Rotted decking from previous leaks. GAF says this can add a few hours to an extra day
  • Damaged fascia or soffit that needs carpentry work
  • Inadequate ventilation that needs new vents

Professional contractors include contingency language in contracts for this. Homeowners rarely expect the timeline impact. Plan for extra time if your roof is old or has a leak history.

Phase 3: Deck Repair and Preparation

If your roof deck is sound, crews move directly to installation. If repairs are needed, this adds time.

Deck Replacement

Decking must meet code and span requirements for your rafter spacing. Common choices are OSB or plywood sheathing. The more decking that needs replacing, the longer this phase runs.

Ice dams along the eaves are a common cause of deck damage.

Underlayment Installation

Once the deck is solid, crews install:

  1. Ice barrier along eaves and valleys where required
  2. Synthetic underlayment across the remaining roof surface
  3. Drip edge along the edges

This often happens the same day installation begins.

Phase 4: Shingle Installation

Contractors quote this phase when they say it is a one or two day job.

Installation Time by Roof Type

GAF says pitches generally steeper than 8:12 need specialized safety equipment. Crews cannot work as fast on them.

Roofs with many planes, angles, and penetrations take longer, since crews cut more shingles.

Metal panels generally take longer than asphalt shingles. Ask your contractor for a written estimate for your roof.

Installation Sequence

A typical sequence looks like this:

  • Starter strip along the eaves
  • Field shingles from eave to ridge
  • Valley metal, if the roof has valleys
  • Hip and ridge cap
  • Chimney and vent flashing

Weather permitting, many residential roofs finish shingle installation within a few days.

Phase 5: Finishing Details

Flashing and Penetrations

Proper flashing around chimneys, skylights, and plumbing vents is critical for preventing leaks. Quality contractors spend extra time on:

  • Chimney flashing: step flashing, counter flashing, and a cricket where needed
  • Skylight flashing: done per the skylight maker's instructions
  • Vent pipe boots: replaced rather than reused

Gutter Reinstallation

If your gutters were removed for roof access, reinstalling them adds time. Some contractors recommend replacing old gutters during roof replacement. That avoids future removal costs.

Final Cleanup

Professional crews perform:

  • Magnetic nail sweep: critical for finding dropped nails
  • Dumpster removal: confirm the pickup date with your contractor
  • Debris inspection: a walk around the property perimeter for missed materials
  • Attic inspection: verify no nails came through the decking

A Typical Installation Day

Here is a general sequence for a standard single-family home. Times and order vary by crew.

  • Morning: The crew arrives and stages equipment. Tarps or plywood go down around the perimeter to catch nails and debris.
  • Tear-off: Old shingles go into a dump trailer or dumpster. The crew inspects the exposed decking and marks soft or rotted sections.
  • Prep: Decking repairs are finished. Ice barrier and drip edge go in, then underlayment across the field.
  • Shingles: They go on from eave to ridge. The crew sets flashing, replaces pipe boots, and installs ridge cap.
  • Wrap-up: The crew inspects the finished surface. A magnetic roller sweeps the yard and driveway for nails. Old material is hauled away, and you walk the site with the crew lead.

Larger homes, complex shapes, or heavy decking damage push the job into a second day. If the crew has not reached the ridge, they tarp the open section before leaving.

The Weather Wild Card: Ohio-Specific Delays

Weather is a leading cause of schedule changes in Ohio roofing projects.

Conditions That Halt Work

  • Rain: Crews generally stop, since moisture hurts shingle adhesion and creates slip hazards
  • Strong winds: A safety risk for elevated work
  • Cold weather: Shingles seal more slowly and become less flexible. See ARMA's cold-weather installation recommendations and follow the maker's temperature limits
  • Extreme heat: A worker safety concern

What Manufacturers and Industry Groups Say

GAF says afternoon rain can leave a roof partly done until the next day. GAF also says frost on the roof can make work dangerous. Crews may take extra precautions or start after the frost is gone.

The Asphalt Roofing Manufacturers Association (ARMA) gives cold-weather guidance.

  • It says to pick a temperature where shingles stay flexible.
  • It gives no set temperature and points to the maker's instructions.
  • It says most shingles use a thermally activated sealant. The sealant bonds shingles together after they are applied.
  • It says sealing time varies with roof slope, orientation, and sun or heat exposure.
  • It says shingles can be hand-sealed in very cold weather.
  • Use an adhesive the shingle maker accepts.

Check your shingle maker's instructions for exact temperature limits.

Seasonal Delay Expectations

Delay risk varies by season. This is general guidance, not measured data.

Season Delay Risk Typical Cause
Spring Moderate to high Frequent rain systems
Summer Lower Afternoon thunderstorms
Fall Lower to moderate Early season weather fronts
Winter Highest Snow, ice, cold temperatures

A wet spring can delay several projects at once, so build in extra time.

Contractor Weather Protocols

Reputable contractors watch the forecast ahead of time and will:

  • Delay tear-off if rain is expected soon
  • Tarp exposed sections if surprise weather develops
  • Resume work only after surfaces dry

Total Timeline by Project Type

GAF gives one to two days of on-site work for an average asphalt roof. No source publishes Ohio-wide durations for permits, deliveries, or weather. Ask your contractor for a written schedule.

Standard Asphalt Shingle Replacement

  • Best case: Materials are in stock, the permit clears fast, and the weather holds. On-site work is short.
  • Normal case: A permit wait, a delivery wait, and a weather delay add up. The total often runs a few weeks.
  • Worst case: Slow permits, repeated weather delays, and structural repairs stretch the project further.

Premium Metal Roof Installation

Metal roofing requires precision cutting and fastening, which slows installation:

  • Panels are often made to order, so materials take longer to arrive
  • On-site work usually runs longer than for asphalt
  • Weather sensitivity is similar to asphalt

Other Common Schedule Disruptors

Beyond weather and permits, three things often push a job past its date.

Extensive decking damage. According to GAF, rotted plywood can add a few hours to an extra day. Homes with long-undetected leaks or ice dam damage are most at risk.

Contractors budget an allowance but cannot know the scope until tear-off.

Specialty materials. Common shingle lines from major makers rarely cause delays. Limited-run colors and premium lines can take longer.

Standing seam metal panels are often fabricated to order. Special-order pipe boots and custom flashing can also run late. So can low-slope membrane.

A good contractor checks accessory availability when ordering, not after tear-off.

Crew conflicts. A crew whose prior job ran over pushes your job back. Good contractors tell you early when this happens.

How Far in Advance Should You Schedule?

In spring peak season, quality Fairfield County crews may book several weeks out. Call early if you want a May or June job.

Late summer and fall lead times are often shorter for non-emergency work. Some contractors price more competitively off-peak. Ask for current availability.

Winter scheduling is possible. Weather uncertainty rises and crews are harder to book.

Working toward a hard deadline? Home sale closings and insurance deadlines need buffer, so start your contractor search early.

Build extra time beyond the expected completion date.

How to Minimize Delays

Before Project Starts

  1. Schedule during optimal weather windows: Late spring through early fall often offers the most stable conditions in Ohio
  2. Confirm material availability before signing: Ask for documentation that materials are in stock or confirm ship date
  3. Choose contractors with permit experience: Established local contractors have streamlined permit processes
  4. Prepare your property: Clear driveway access, move vehicles, trim overhanging branches

During Installation

  1. Maintain clear communication: Ask for daily updates if project extends beyond quoted timeline
  2. Document everything: Photo progress daily, especially if insurance is covering the work
  3. Be flexible with schedule: Weather delays are beyond contractor control, so focus on quality over speed
  4. Address concerns immediately: Don't wait until final day to raise quality issues

Red Flags That Indicate Problems

While weather delays are normal, these situations warrant concern:

  • Project stalls for days with no communication: Professional contractors proactively update clients on delays
  • Crew disappears mid-project: Could indicate contractor is juggling too many jobs
  • Exposed roof left overnight without tarping: Check your contract for who is responsible for interior water damage
  • Permits not posted visibly: Building inspectors can halt unpermitted work

Living in Your Home During Replacement

What to Expect

You don't need to vacate, but daily life changes during roof work:

Noise levels: The tear-off phase sounds like constant hammering directly overhead. Installation is quieter but still disruptive. Families with infants or noise-sensitive pets often stay elsewhere during active work days.

Vibrations: Expect wall decorations to shift or fall. Remove fragile items from shelves. Do it the night before work begins.

Dust and debris: Despite precautions, attic dust filters into living spaces. Cover furniture in rooms directly below roof work.

Bathroom access: Contractors may need outdoor water access for cleanup. Tell them which spigots work.

Driveway/parking: Dumpsters and material deliveries occupy driveway space for several days. Plan alternative parking.

Protecting Your Property

  1. Move vehicles away from the home: Falling debris is common despite safety measures
  2. Cover pool/hot tub: Roofing debris damages pool liners and filtration systems
  3. Protect landscaping: Request plywood walkways over garden beds if crew access required
  4. Secure pets indoors: Open gates and loud noises stress animals

Final Inspection and Warranty Activation

Municipal Inspection

Many jurisdictions require inspections when a permit is issued. Your contractor usually schedules them. Ask the building department which inspections apply and how soon they happen.

Inspectors may check:

  • Shingle installation and nailing patterns
  • Ventilation
  • Flashing around penetrations
  • Compliance with code requirements

A failed inspection adds time for corrections and re-inspection.

Manufacturer Warranty Registration

Some shingle makers require warranty registration within a set window. Check yours. Your contractor may handle this, but verify you receive:

  • Copy of warranty registration confirmation
  • Material warranty documentation
  • Workmanship warranty from the contractor

Frequently Asked Questions

Can I speed up the timeline by doing prep work myself?

Homeowner prep has minimal impact on installation timeline but helps indirectly. Clearing ground-level access, moving patio furniture, and trimming branches saves some setup time. However, never attempt roof work yourself, because the safety risks outweigh any time savings.

What happens if it rains mid-installation?

Professional crews immediately tarp exposed sections with heavy-duty waterproof tarps secured with boards. Modern synthetic underlayment provides some water resistance, but tarping prevents water intrusion. Your contract should specify that weather delays are no-cost extensions.

Should I be home during installation?

Not required, but recommended for at least the first day. Being present allows you to:

  • Answer questions about property access
  • Address any immediate concerns
  • Verify crew professionalism and safety practices
  • Document the work progress

After the first day, daily presence isn't necessary if you trust your contractor.

How long before I can walk on my new roof?

Asphalt shingles can be walked on after installation. Avoid unnecessary foot traffic while the sealant strips cure, and follow the manufacturer's guidance. Metal roofs can be walked on immediately with proper footwear (soft-soled shoes to avoid scratching).

Never walk on slate or tile roofs without professional guidance, because they can crack.

How long does it take to get a roofing permit in Lancaster, Ohio?

The city publishes no re-roof permit review time, and other offices set their own timing. Confirm with the City of Lancaster Certified Building Department.

Work should not begin before the permit is issued. Confirm your contractor pulls it first.

How far in advance should I schedule a roof replacement in Ohio?

In spring peak season, quality Fairfield County crews may book several weeks out. Start calling contractors early. Late summer and fall booking windows are often shorter.

With a hard deadline, add buffer and start early.

How long does a typical roof replacement take in Ohio?

According to GAF, an average asphalt shingle roof often takes one to two days. Permits, material delivery, and weather can stretch the total project. Larger, metal, or complex roofs may take longer.

Ask your contractor for a written schedule.

What causes delays in roof replacement projects?

Weather is the most common cause of delays in Ohio. Rain, strong winds, and extreme temperatures halt work. Other delays come from hidden structural damage found during tear-off, material delivery, and permit processing.

GAF says rotted decking can add a few hours to an extra day. Spring storms can add delays.

Can roofers work in light rain?

Roofers generally stop work in rain. Moisture can hurt shingle adhesion and creates slip hazards. Crews tarp exposed areas.

Follow the manufacturer's installation instructions.

Do I need to leave my home during roof replacement?

You do not need to leave during most roof replacements. Expect heavy noise during tear-off. Vibrations may shake items on walls.

Families with young children, pets, or noise-sensitive people sometimes stay elsewhere during active work.

How long before I can use my attic after roof replacement?

Attic use usually resumes once the crew finishes cleanup. Expect some dust and debris.

Vacuum before storing items, and ask the contractor to confirm nails and materials were removed.

Plan Ahead for a Smooth Roof Replacement

A short project and a long one often differ by factors you can control. Choose experienced contractors. Schedule in good weather windows.

Keep realistic expectations.

Fairfield Peak Roofing connects homeowners with independent local contractors. Many provide project timelines during the estimate. Ask yours for a written schedule and how it will communicate delays.

Want a timeline based on your specific home? Request a contractor estimate or call 877-367-1885 to ask about availability.

Knowing what to expect makes the process less stressful. It helps you plan around delays.

roof replacement timeline planning guide project duration

Ready to Start Your Roof Replacement?

Get a detailed project timeline and accurate estimate from Lancaster's trusted roofing team.
